These photos show the construction of the beamline as it happened. Hover over or click on an image for a caption.

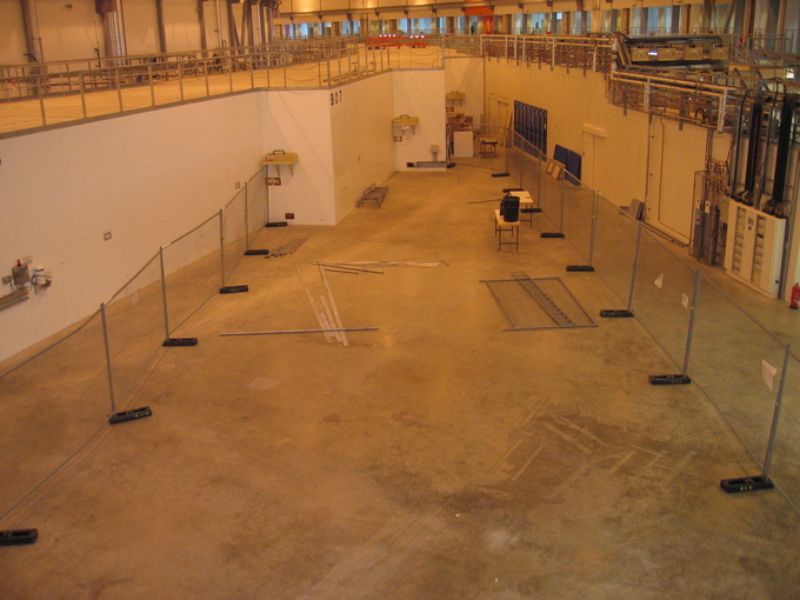

17 May 2007: The area of the experimental hall where I07 will be built is cleared

1 July 2007: Construction begins

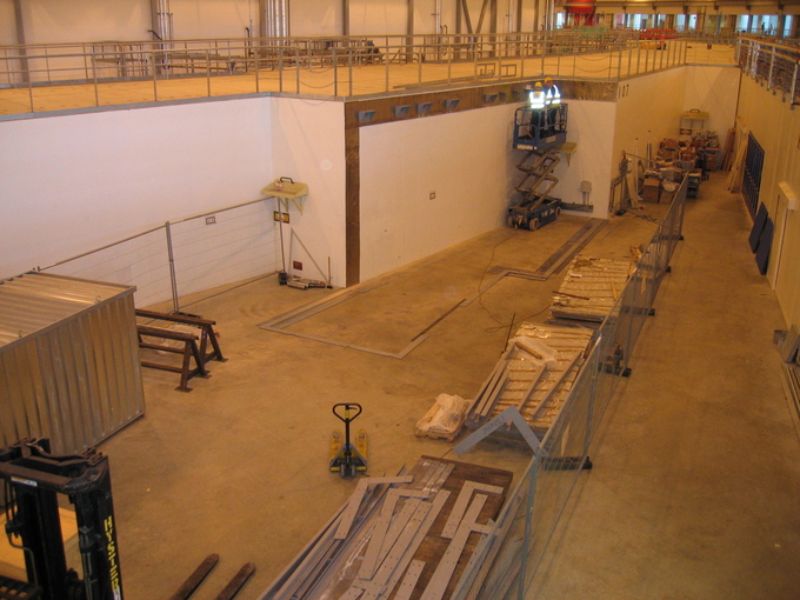

12 July 2007: The fixings for the hutches are attached to the ratchet wall in preparation

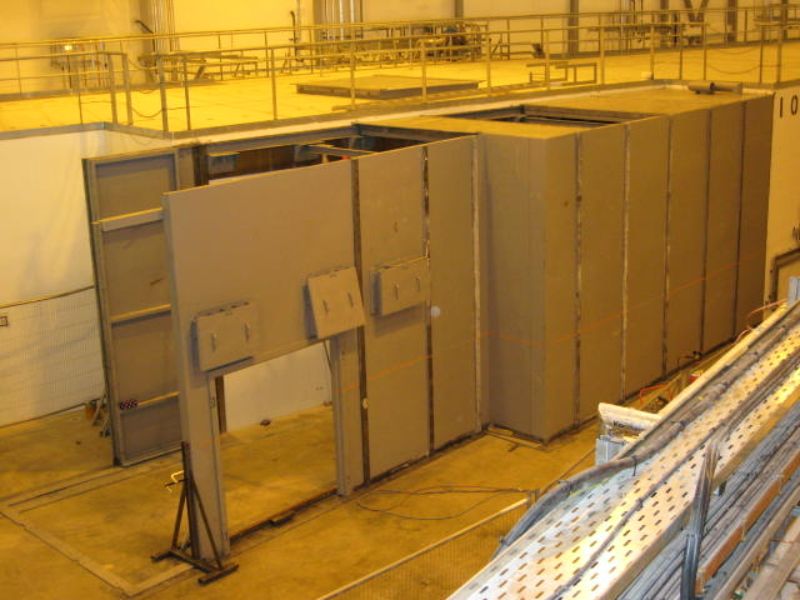

30 July 2007: Construction of the Optics hutch is almost complete

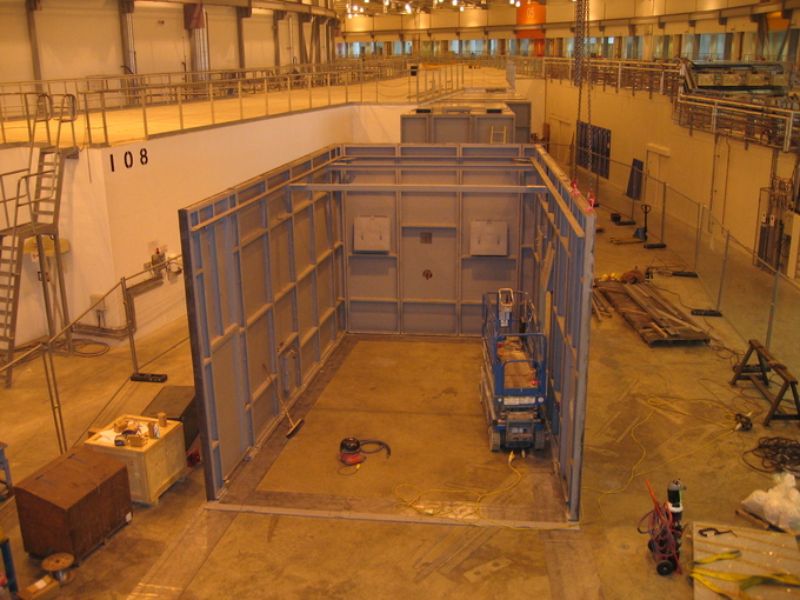

9 August 2007: The first Experimental Hutch (EH1) under construction

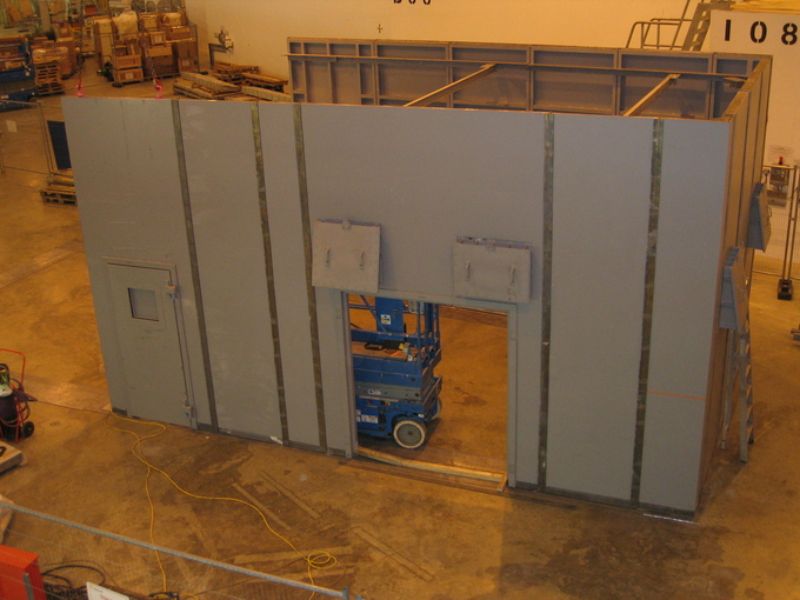

9 August 2007: Construction continues on EH1

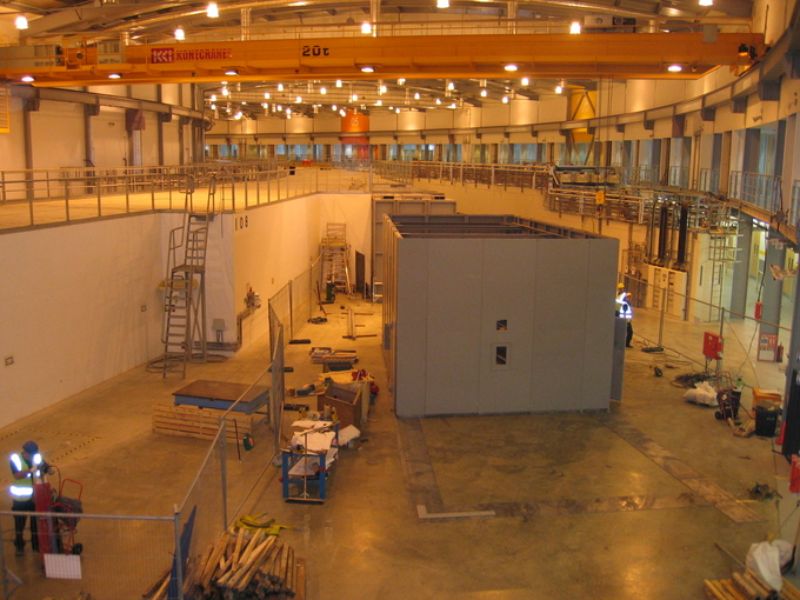

13 August 2007: The first experimental hutch is complete

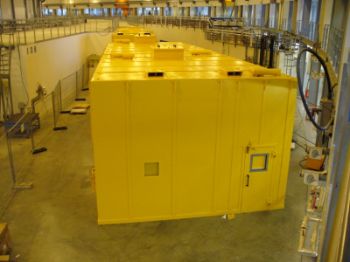

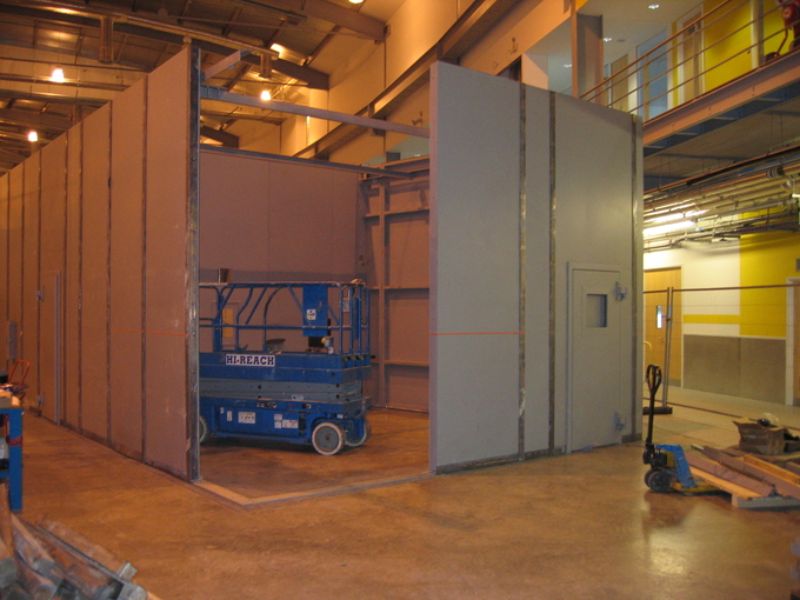

16 August 2007: The second experimental hutch (EH2) is almost complete

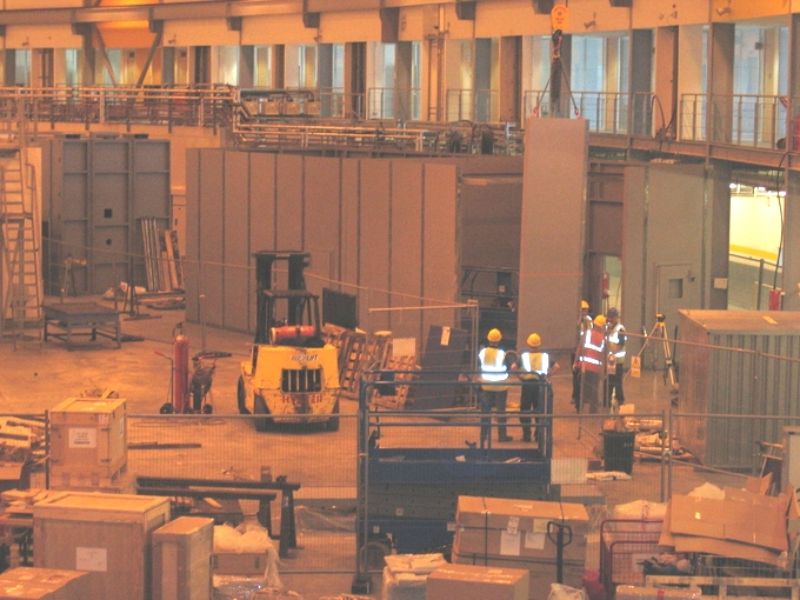

16 August 2007: The last panels are lifted into place

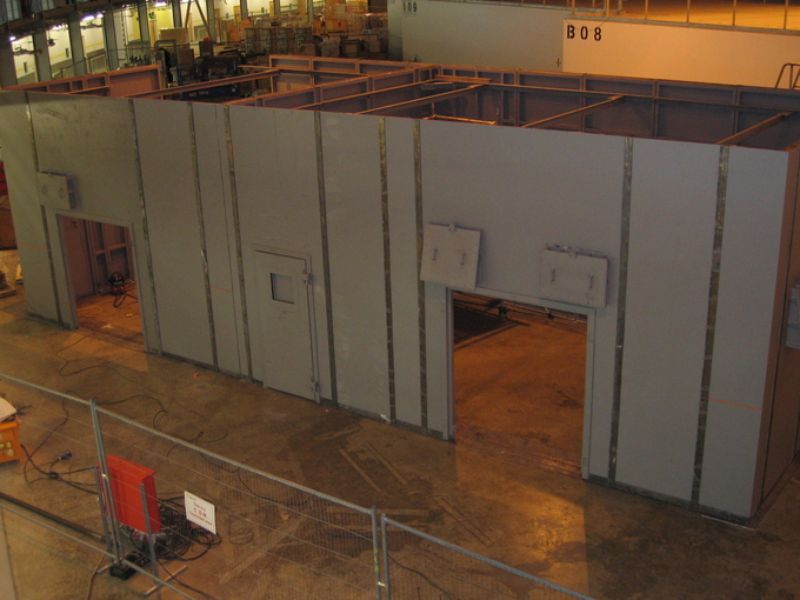

16 August 2007: The two experimental hutches

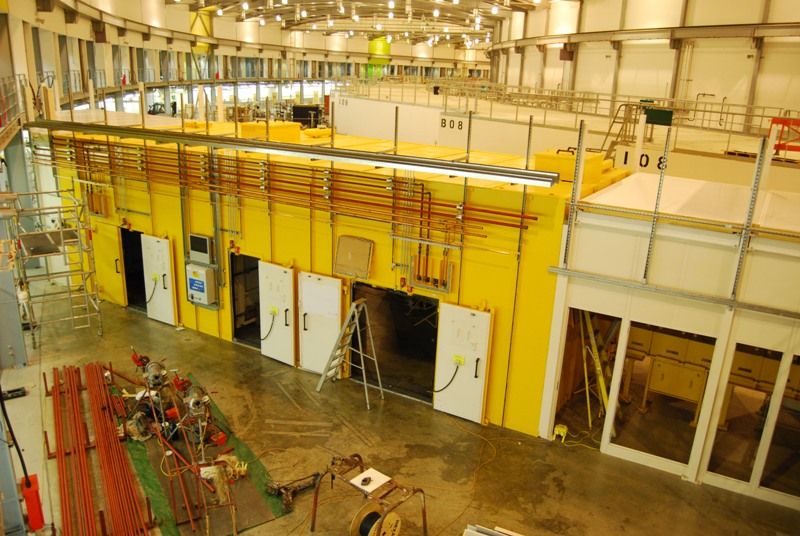

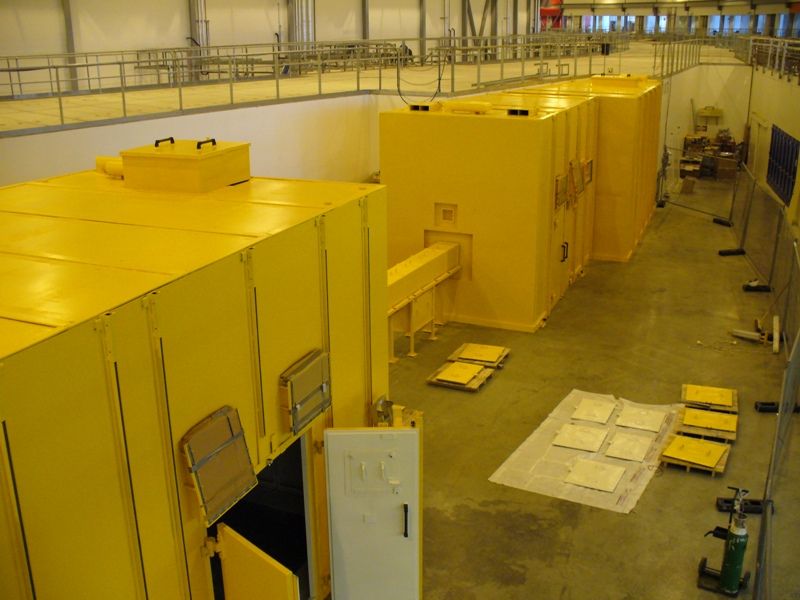

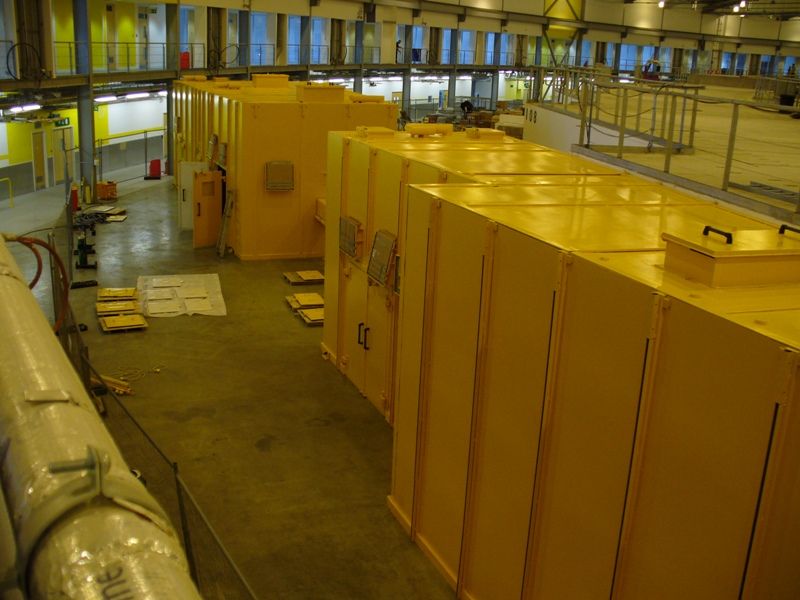

24 October 2007: The I07 hutches after they have been spray-painted yellow
24 October 2007: The experimental hutch
24 October 2007: The I07 hutches

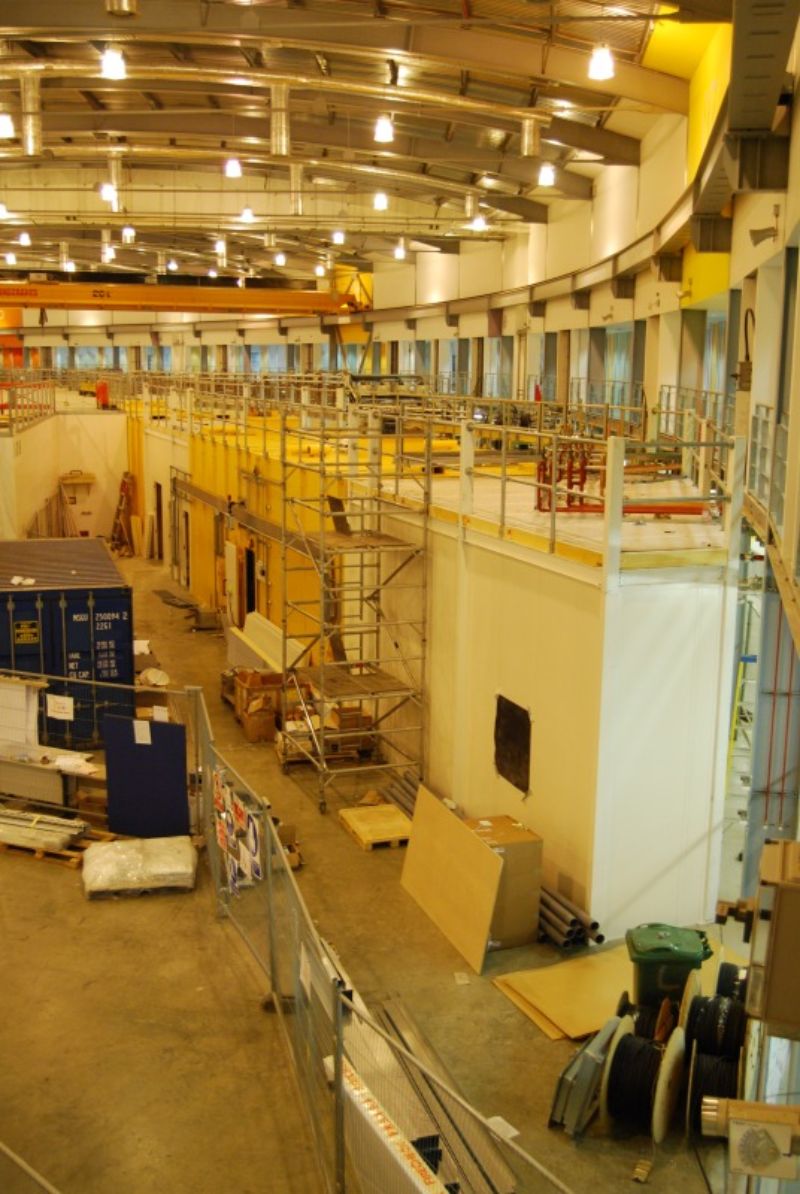

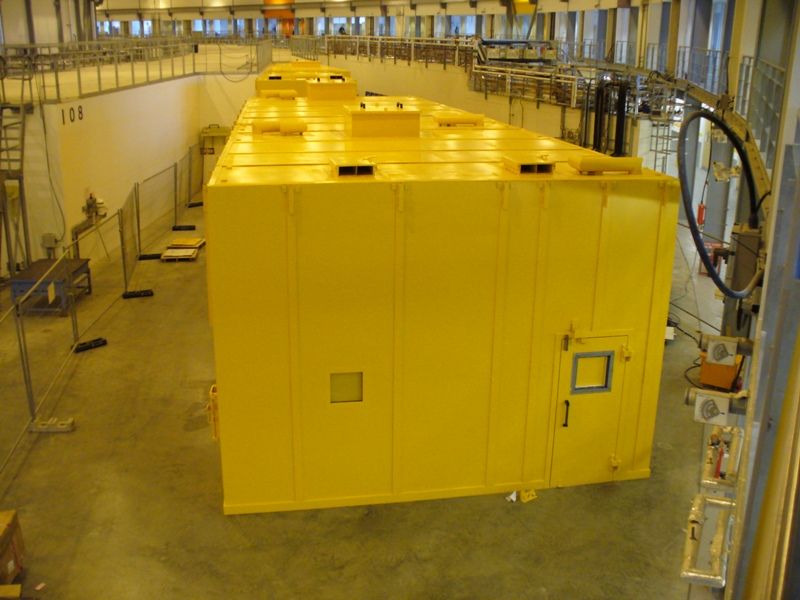

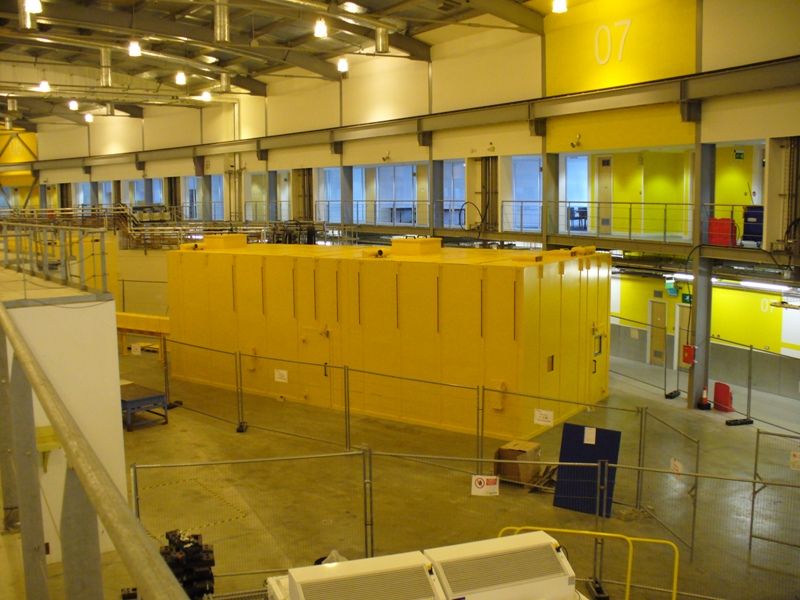

24 October 2007: The I07 hutches are complete

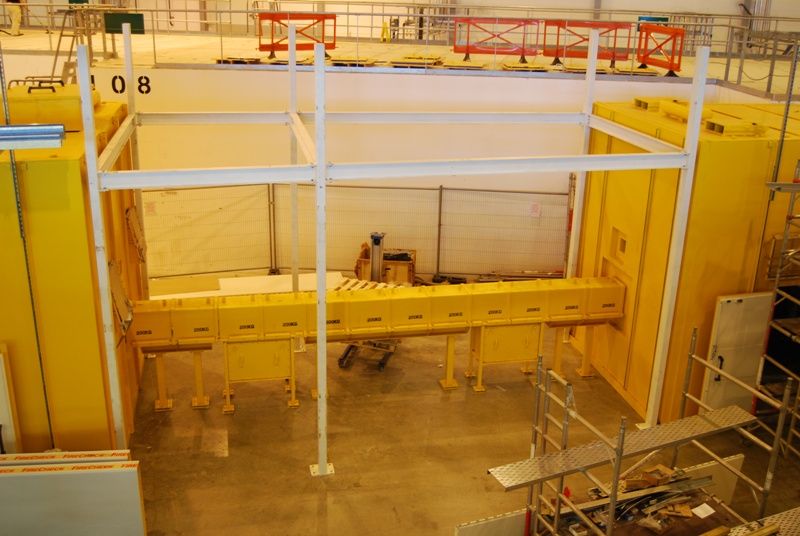

2 September 2008: Steelwork for the control and instrumentation area (CIA)
2 September 2008: The control cabin takes shape

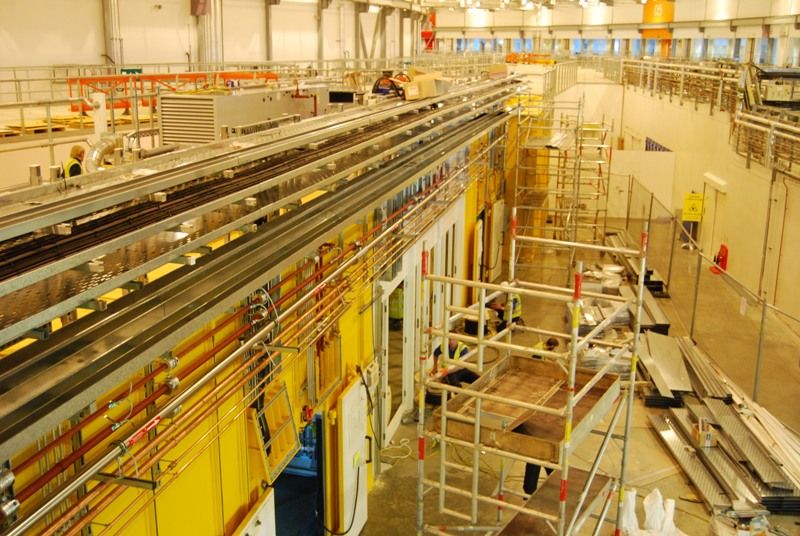

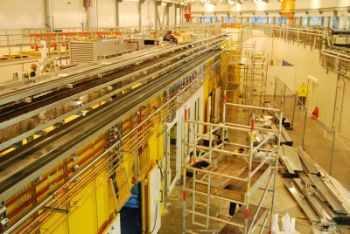

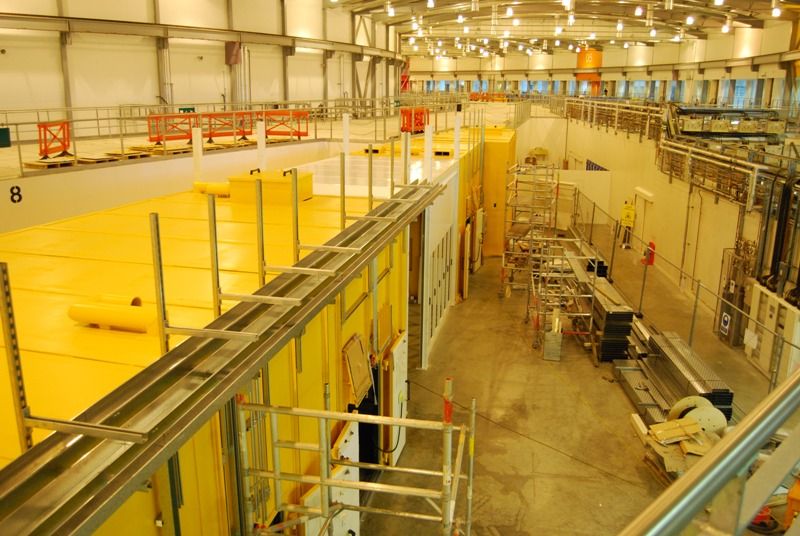

22 September 2008: View along the beamline
22 September 2008: Beamline components assembled on the hall floor pre-installation
28 October 2008: Beamline components
28 October 2008: Pipework being installed
12 November 2008: Handrails fitted
9 December 2008: Services nearing completion

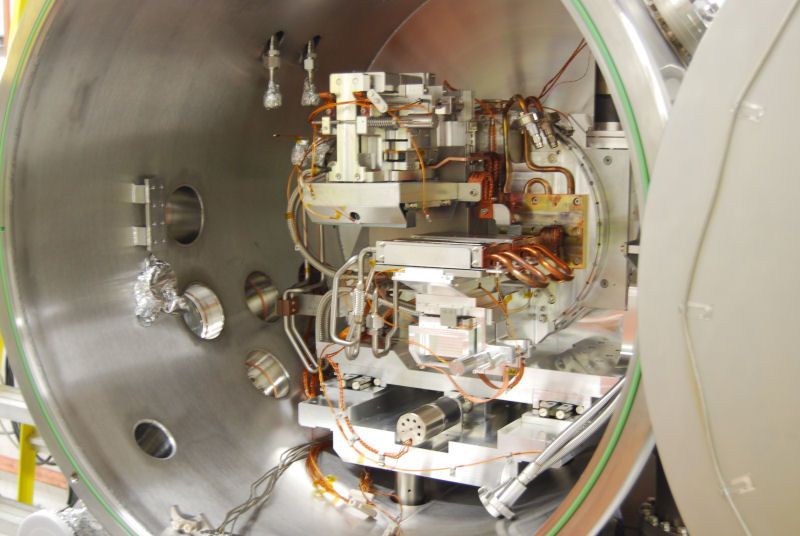

February 2009: Internal view of Double Crystal Monochromator

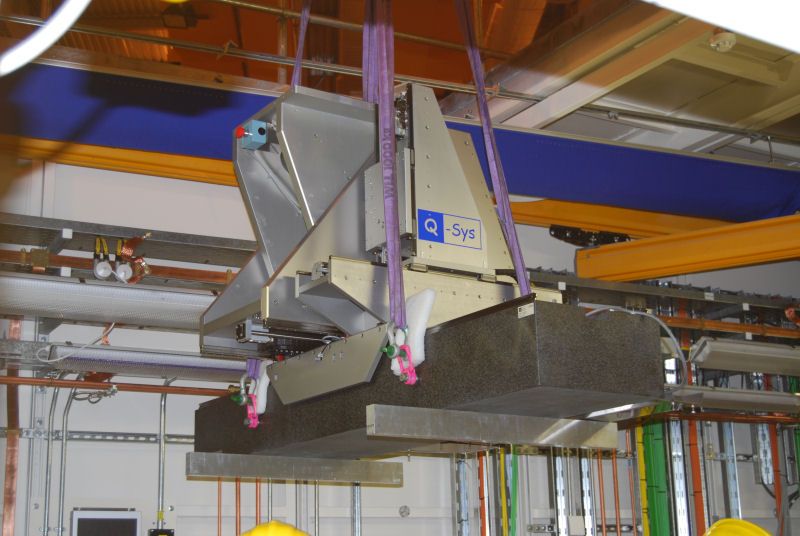

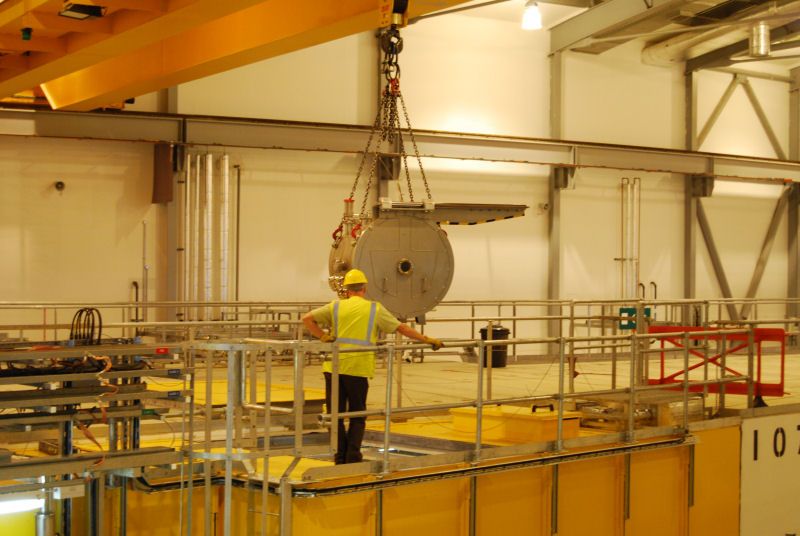

February 2009: Double Crystal Monochromator lifted into optics hutch

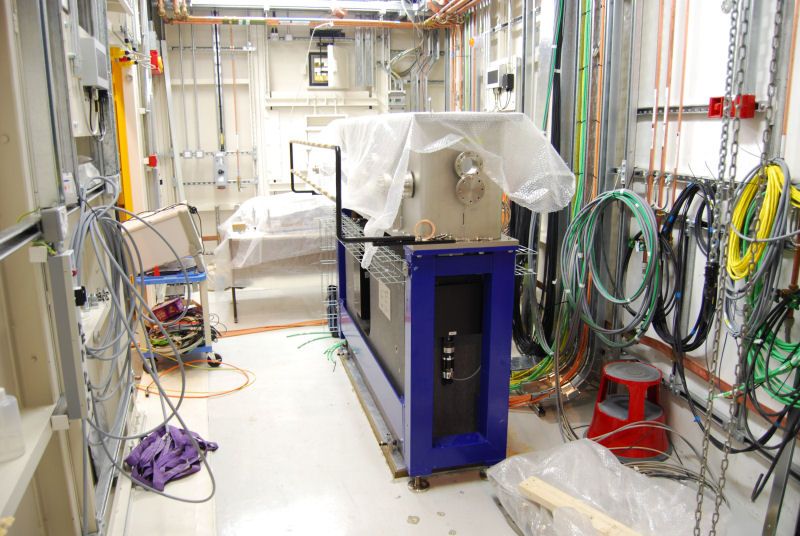

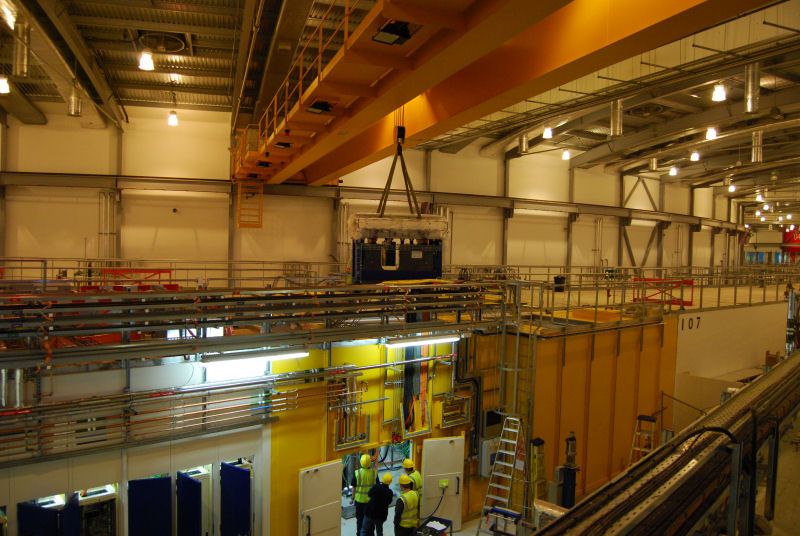

February 2009: KB Mirrors lifted into optics hutch
February 2009: KB Mirrors in place in the optics hutch

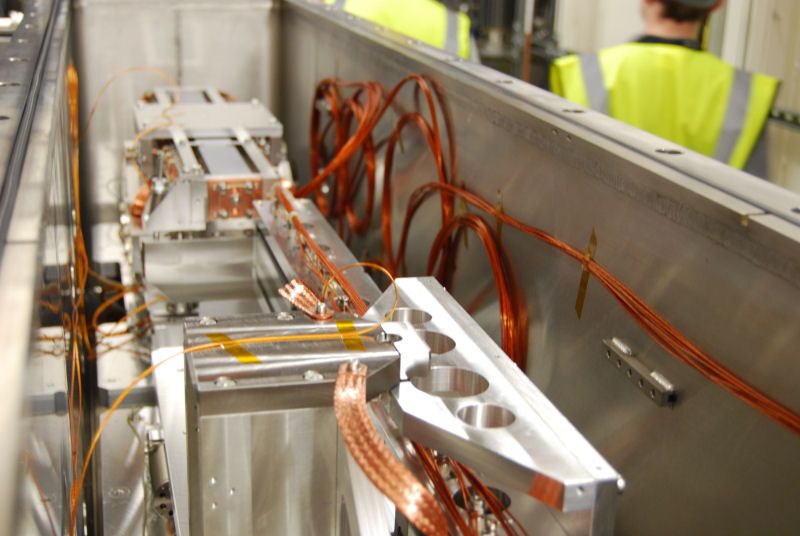

March 2009: Internal view of mirrors after installation

March 2009: Control room furniture is installed

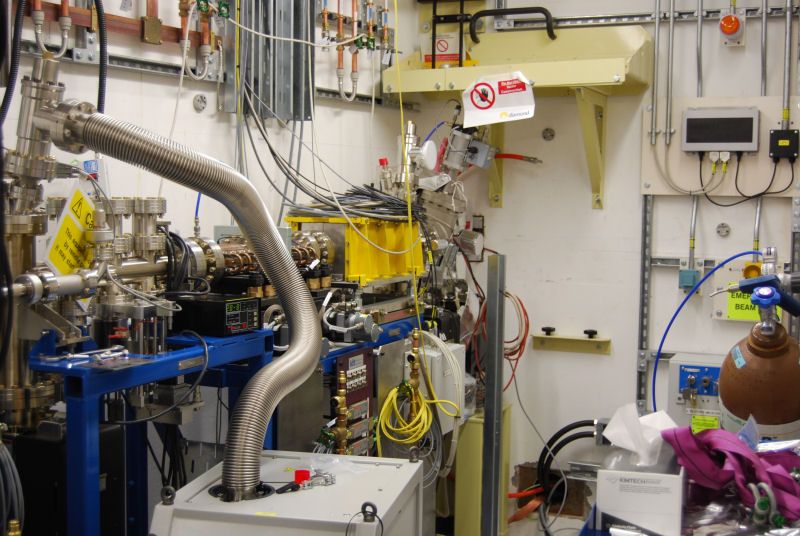

March 2009: Components installed in optics hutch
March 2009: Components installed in optics hutch
March 2009: Large Area Detector Positioning system is installed in first experimental hutch

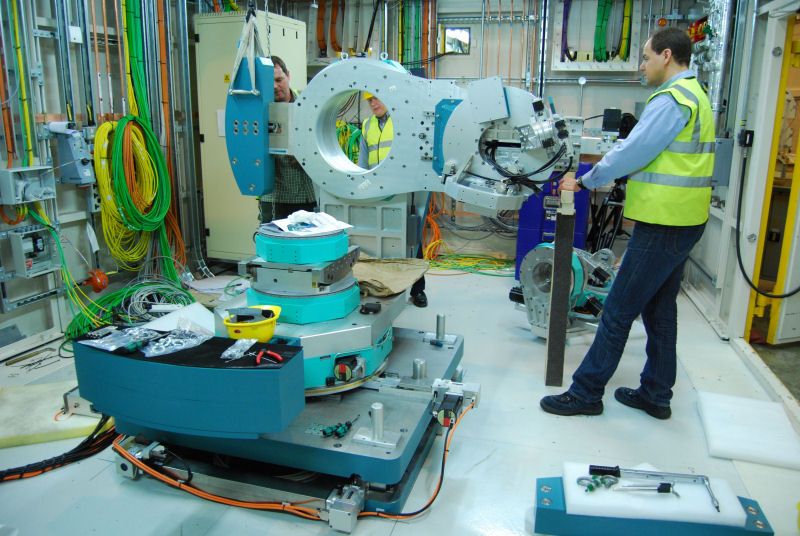

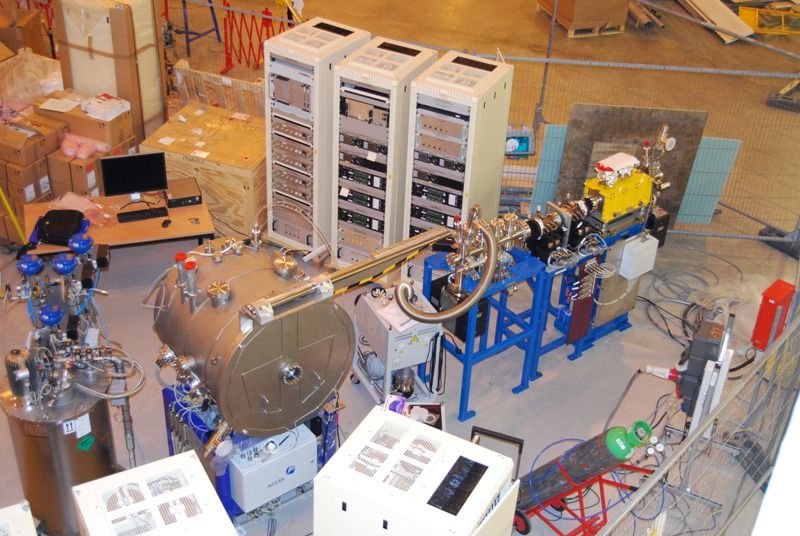

April 2009: Diffractometer Installation

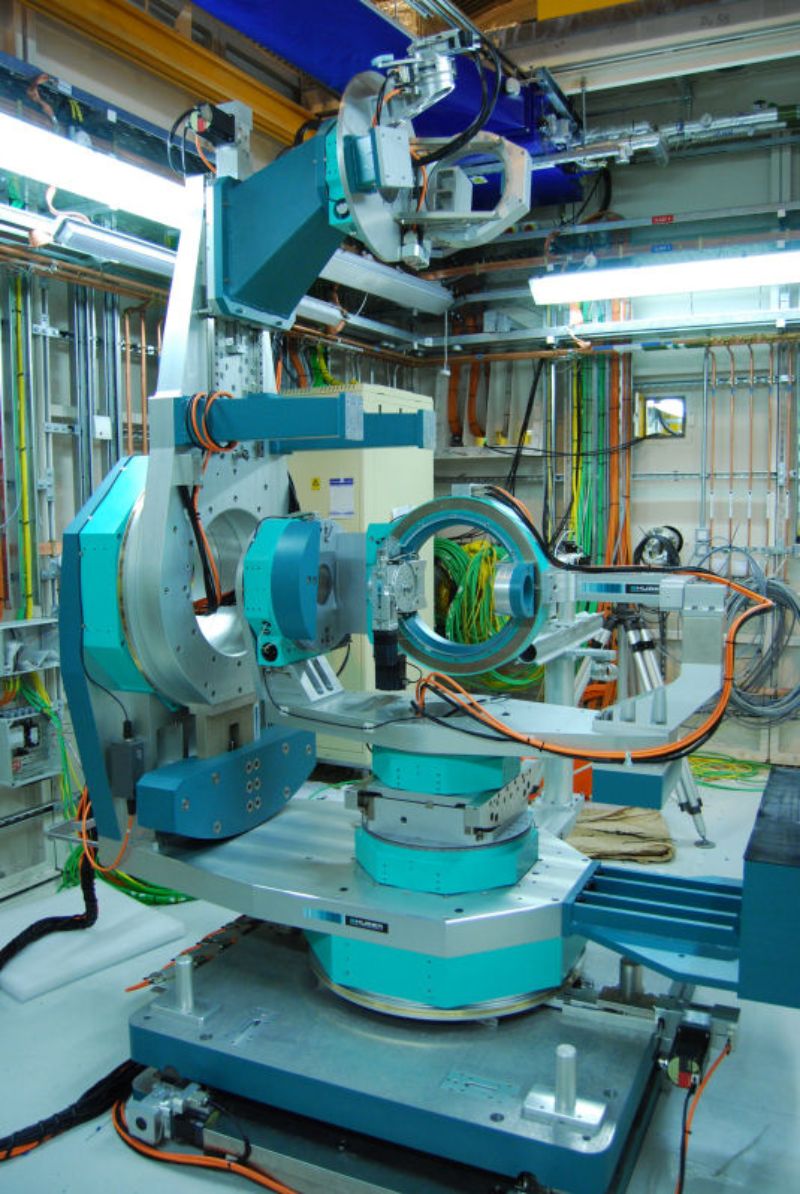

April 2009: Diffractometer installed in first experimental hutch

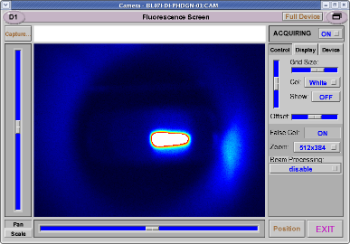

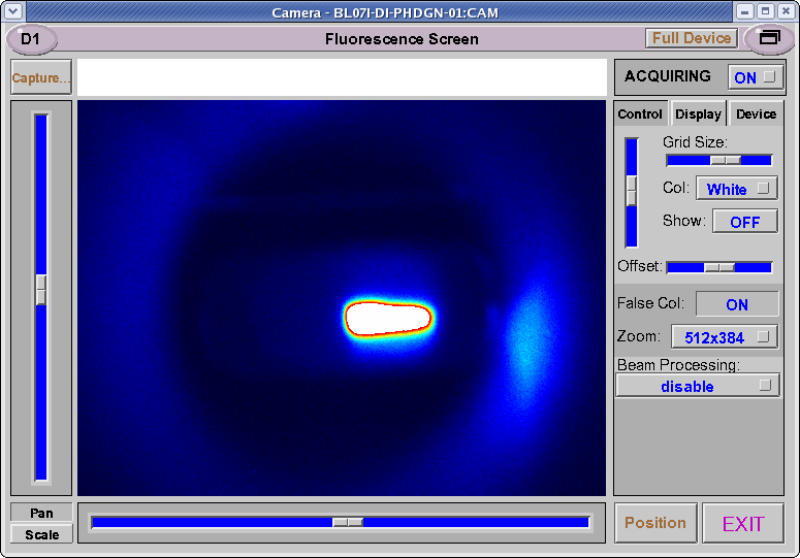

May 2009: First Light!

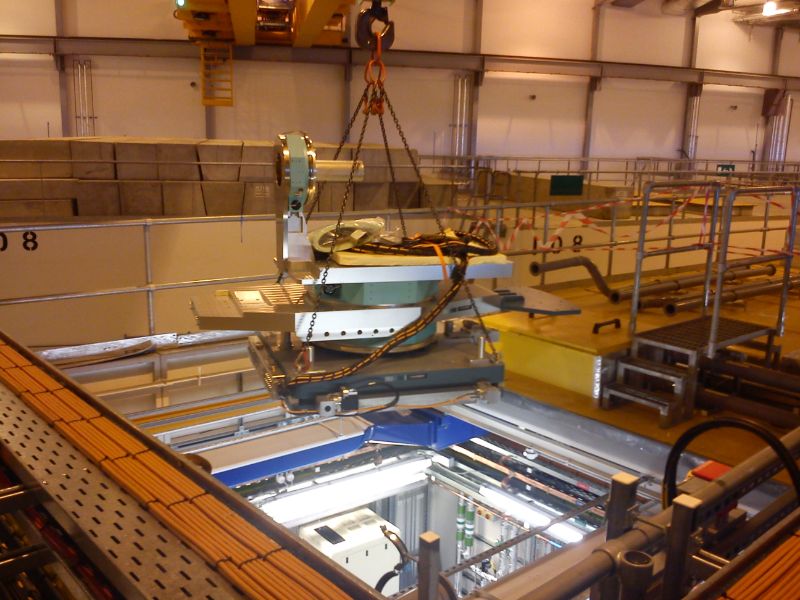

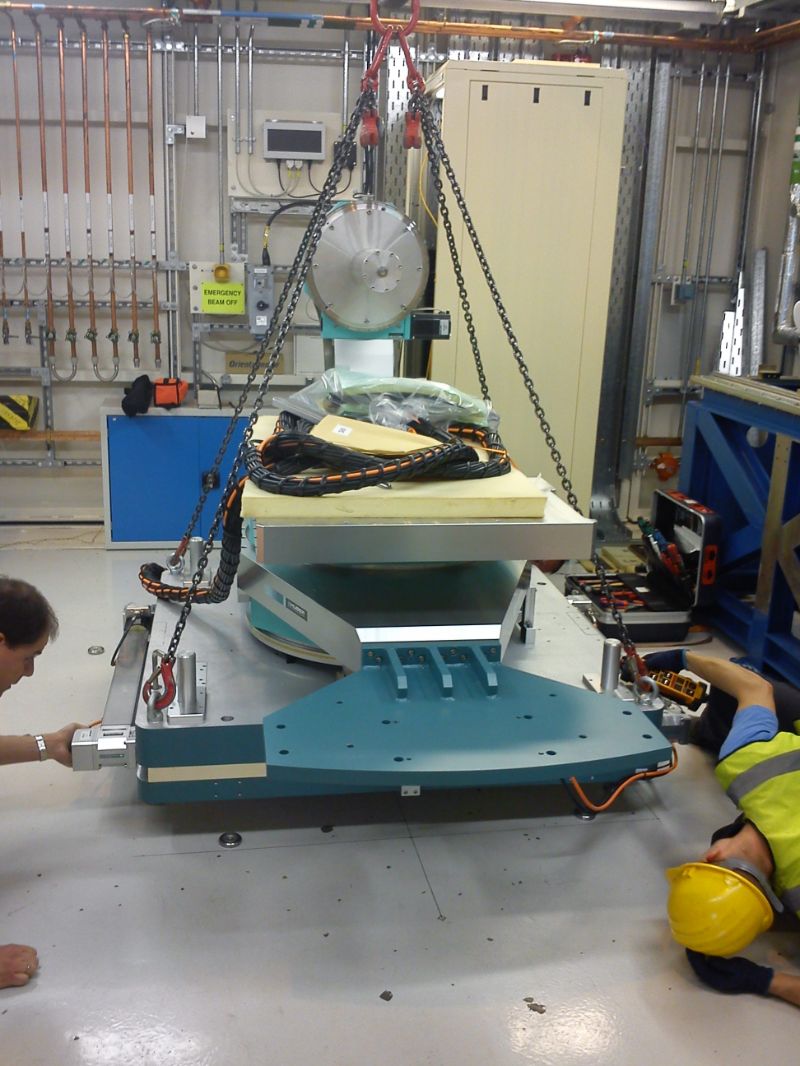

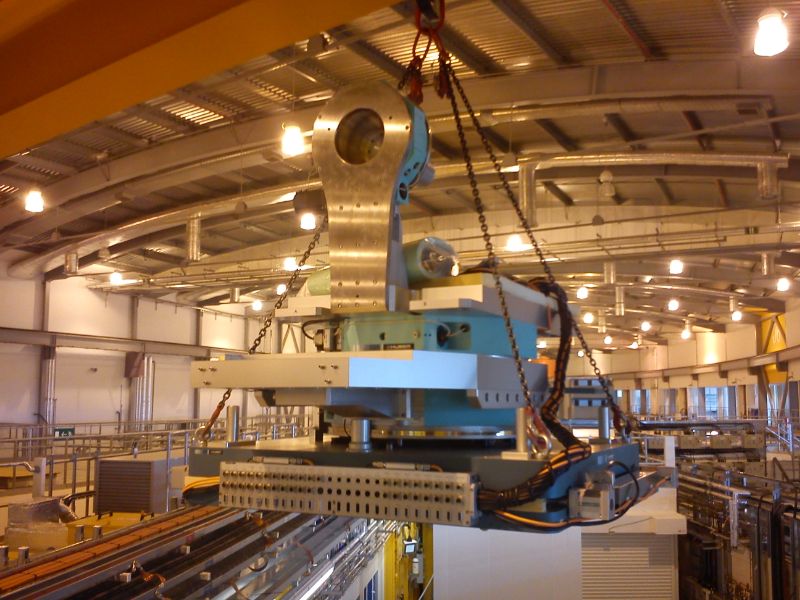

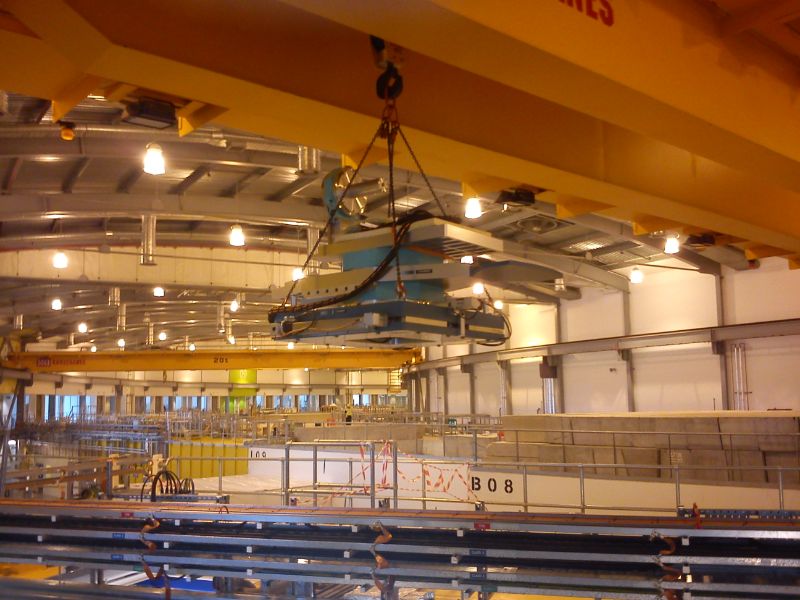

21 June 2011: Diffractometer being lifted into EH2
21 June 2011: Diffractometer being lifted into EH2
21 June 2011: Diffractometer being lowered into EH2
21 June 2011: Installation of EH2 diffractometer
17 May 2007: The area of the experimental hall where I07 will be built is cleared
1 July 2007: Construction begins
12 July 2007: The fixings for the hutches are attached to the ratchet wall in preparation
30 July 2007: Construction of the Optics hutch is almost complete
9 August 2007: The first Experimental Hutch (EH1) under construction
9 August 2007: Construction continues on EH1
13 August 2007: The first experimental hutch is complete
16 August 2007: The second experimental hutch (EH2) is almost complete
16 August 2007: The last panels are lifted into place
16 August 2007: The two experimental hutches
24 October 2007: The I07 hutches after they have been spray-painted yellow
24 October 2007: The experimental hutch
24 October 2007: The I07 hutches
24 October 2007: The I07 hutches are complete
2 September 2008: Steelwork for the control and instrumentation area (CIA)
2 September 2008: The control cabin takes shape
22 September 2008: View along the beamline
22 September 2008: Beamline components assembled on the hall floor pre-installation
28 October 2008: Beamline components
28 October 2008: Pipework being installed
12 November 2008: Handrails fitted
9 December 2008: Services nearing completion
February 2009: Internal view of Double Crystal Monochromator
February 2009: Double Crystal Monochromator lifted into optics hutch
February 2009: KB Mirrors lifted into optics hutch
February 2009: KB Mirrors in place in the optics hutch
March 2009: Internal view of mirrors after installation
March 2009: Control room furniture is installed
March 2009: Components installed in optics hutch
March 2009: Components installed in optics hutch
March 2009: Large Area Detector Positioning system is installed in first experimental hutch
April 2009: Diffractometer Installation
April 2009: Diffractometer installed in first experimental hutch
May 2009: First Light!
21 June 2011: Diffractometer being lifted into EH2
21 June 2011: Diffractometer being lifted into EH2
21 June 2011: Diffractometer being lowered into EH2
21 June 2011: Installation of EH2 diffractometer
A timelapse video of the installation of the I07 cabins and services.
Diamond Light Source is the UK's national synchrotron science facility, located at the Harwell Science and Innovation Campus in Oxfordshire.
Diamond Light Source Ltd
Diamond House
Harwell Science & Innovation Campus
Didcot
Oxfordshire
OX11 0DE
Copyright © Diamond Light Source. Diamond Light Source® and the Diamond logo are registered trademarks of Diamond Light Source Ltd
Registered in England and Wales at Diamond House, Harwell Science and Innovation Campus, Didcot, Oxfordshire, OX11 0DE, United Kingdom. Company number: 4375679. VAT number: 287 461 957. Economic Operators Registration and Identification (EORI) number: GB287461957003.
